Nor'West Arc cycleway and wastewater upgrades

We’re building the northernmost section of the Nor'West Arc cycleway to make it safer and easier for people to cycle in Papanui. We're also upgrading wastewater pipes in the area at the same time.

Sign up for updates about the Nor'West Arc cycleway

In January 2025, work began on constructing the northernmost section of Te Ara O-Rakipaoa Nor'West Arc cycleway. We're also completing wastewater pipe renewals in the area, installing a new stormwater network, making water supply upgrades, and completing a street renewal on Aorangi Road.

These projects have been programmed together to ensure a coordinated approach to work in the area.

Stages

The work is being completed in three stages, with the full project scope expected to be completed by the end of 2027:

  • Stage 1 – Aorangi Road between Brookside Terrace and Condell Avenue was completed in February 2026.
  • Stage 2 – Which incorporates Matsons Avenue to Harewood Road, is under construction between May and December 2026. Read our Newsline story for more information. (external link)
  • Stage 3 – Aorangi Road between Ilam Road and Brookside Terrace. Renewed community consultation on the design took place in April/May 2026 and will see a two-way separated cycleway constructed on the northern side of Aorangi Road, alongside wastewater upgrades and full street renewal. Construction timing will be coordinated with the Northwest programme of water and roading upgrades.

View the traffic impacts drop-down tab below for information on the current phase of work and associated impacts.

Work to construct the northernmost section of the Nor’West Arc cycleway has been timed with significant three waters upgrades, to ensure a coordinated approach to work in the area.

The construction programme began in January 2025 and is expected to wrap up by the end of 2027.

The work will be delivered in three stages.

Key works for all three stages of the project

  • We will be replacing old wastewater pipes on Wairakei Road, Aorangi Road, Matsons Avenue, Harewood Road between the railway line and Harris Crescent, and Chapel Street, installing a new stormwater network, and making water supply upgrades.
  • We will be extending the cycleway along the full length of Aorangi Road and Matsons Avenue, connected by a short section on Condell Avenue.
  • We will also construct a small section of the Wheels to Wings cycleway along Harewood Road between Chapel Street and the railway line. This will connect the Northern Line cycleway to the Te Ara A-Rakipaoa Nor'West Arc cycleway.

The completed cycleway and street renewal on Aorangi Road between Brookside Terrace and Condell Avenue.

The second stage of the project incorporates Matsons Avenue, Chapel Street and Harewood Road. Isaac Construction has been appointed as the contractor, and construction works will take place between 2 June and late December 2026.

We know roadworks can be frustrating. We’ve carefully planned our programme to keep traffic flowing and get out of the way as quickly as possible:

Throughout the project, temporary traffic management will be in place to keep road users and contractors safe. Please take care to follow signage and reduce speeds when travelling through the work site.

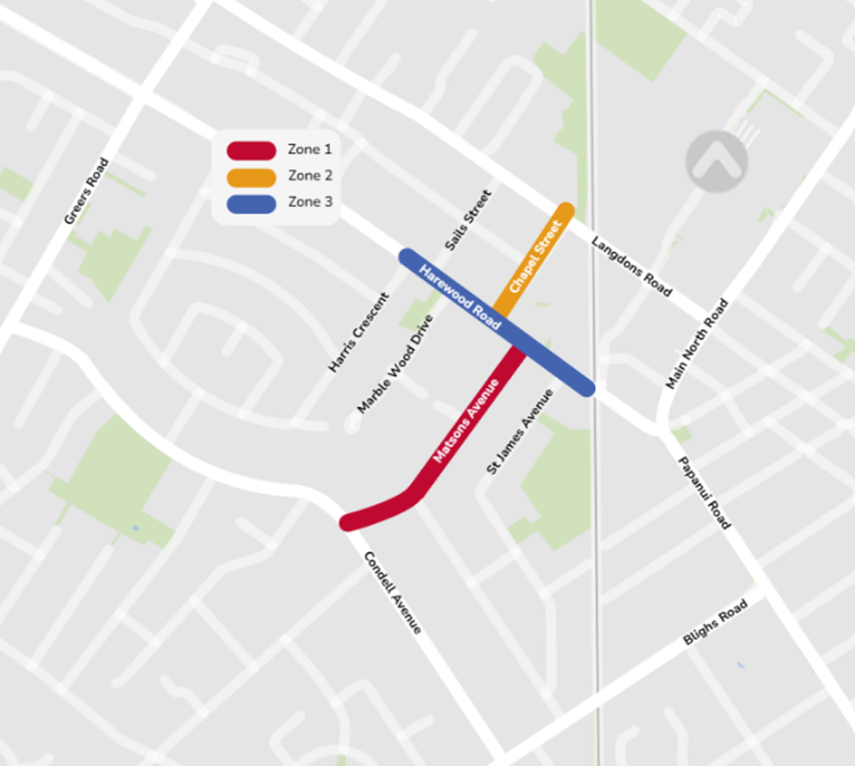

Work will begin at the same time on the three zones, as shown on the map below.

Hours of work

Monday to Friday 7am to 6pm. Some weekend work may be necessary at points throughout the project.

Who to contact for questions about the work

Isaac Construction communications advisor – Hayley: 027 323 0056 or email mcrnorwestarc@isaac.co.nz

Timeframe for the Stage 2 work, incorporating Matsons Avenue to Harewood Road

Main construction is expected to get underway in early June 2026. Read the start works notice(external link).

Vehicle access to properties

There may be temporary disruptions during construction. Please get in touch with the Isaac Construction team on 027 323 0056 to inform them of any access requirements ahead of time.

If a section of the road is closed, alternative access or assistance will be provided.

If you need assistance when exiting or entering your property, please signal to a member of the crew or contact them on the above phone number.

If the construction team need to interrupt your driveway access, they will advise of this prior to doing so through text or door-knocking.

Sign up to receive updates about the work(external link).

Interruptions to electricity, water, or internet

We do not anticipate any major interruptions to services. If any are planned, we will notify affected residents in advance.

Water on the street

Part of our underground work involves the safe management of extracted groundwater. This is the water seen on the roads, which will be carried away via the stormwater system.

On-street parking is available for vehicles once complete

There are areas where on-street parking will be removed, but there will still be plenty of parking spaces retained. The plan has not changed since it was approved in February 2022.

The table below provides some information about the change in on-street parking. The measurements were done in lengths (m), with approximately six metres allocated to one car park.

The percentage of parking retained is approximately 52%.

On Wairakei Road, no car parks have been removed.

Section Existing carpark count Approx. existing length (m) New length (m) Approx. new carpark count
Between Ilam Road and Clyde Road 62 370 190 32
Between Clyde Road and Brookside Terrace 65 390 120 20
Between Brookside Terrace and Wairakei Road 60 360 140 23
Between Wairakei Road and Condell Avenue 122 730 410 68
Condell Avenue 28 170 30 5
Matsons Avenue 110 660 520 86
Totals 447 2680 1410 234

Intersection cameras

Yes, two traffic monitoring cameras have been installed at the Wairakei/Aorangi intersection to help the Council observe traffic flow and respond quickly to any incidents that may occur.

Te Ara O-Rakipaoa Nor'West Arc cycleway connects cyclists from Cashmere to Papanui, via Spreydon, Middleton, Riccarton and Ilam. The route begins at Princess Margaret Hospital in Cashmere and is currently open as far as Jellie Park Recreation and Sport Centre on Ilam Road.

The cycleway provides a safer route for cyclists to get to school, university, work, pools and gym, parks, and local shops. Making it safer for people to bike helps reduce congestion, lowers emissions and makes it easier for cyclists to get around.

At their meeting on Thursday 3 February 2022, the Urban Development and Transport Committee approved the revised scheme design of the Major Cycleway Route Nor’West Arc Section 3.

See the meeting agenda(external link) and minutes(external link) for more information.

Speed consultation decision

At their meeting on 10 December, Christchurch city councillors decided against the proposed lower speed limits for streets associated with the Nor’West Arc cycleway.

People could provide their feedback between 19 September and 31 October 2025.

The speed limit on Aorangi Road, Condell Avenue and Matsons Avenue will remain at 50km/h.



Consultation on Stage 3

A small section of cycleway on Aorangi Road between Ilam Road and Brookside Terrace will be completed as part of the planned street renewal of Aorangi Road.

Renewed community consultation on the design took place in April/May this year and will see a two-way separated cycleway constructed on the northern side of Aorangi Road, alongside wastewater upgrades and full street renewal. The design was approved by the Council on 2 September 2026.

Subscribers of our general project updates(external link) will be notified by email when the project moves into a new stage/phase, and there are changes to traffic management and the work area layout. We may also let you know about key milestones we've achieved.

Newsletters

If you would like to receive more information about the project's progress from our contractor, Isaac Construction, you can sign up(external link) for their email updates, which will be sent more regularly.

Additionally, residents or businesses located within, or close to, the work area can sign up for the contractor's site-specific text alerts and email updates on the work(external link).
